State of the sprint report
The State of the Sprint Report page displays all the sprints with related work items for a value stream selected as the output for the report execution.
- Start, end, and completed dates
- Total issues number
- Percentage issues done
- Story points planned number
- Story points done number
- Issues not pointed number
- Contributors number
- Sprint Burndown chart
- Individual Measures
- Before you generate State of the sprint report, you must install and integrate Handlebars Reporter plugin with DevOps Velocity. For more information, see Handlebars Reporter plugin documentation.
- You must use Handlebars Reporter plugin version 2.0.5 or later to get accurate metrics in Individual Measures section.
- Click .
- Select the State of the Sprint field under the
Report Templates heading on the left side of the
page.Note: When the State of the Sprint field is selected, a vertical blue bar is displayed on the left side of the field to indicate it as the report to run.
- Click Run Report to display the RUN REPORT window.
- Select the required Value Stream from the list.Note: To set a value stream as default, click Set as Default.
- Based on the Value Stream selected, the
Sprints field selects the latest 10 sprints by
default. You can add or remove sprints in the Sprints
field to generate the report.Note: Sprints field is available only for DevOps Velocity 5.1.10 and 5.1.11.
For DevOps Velocity5.1.10, when no sprints are selected in Sprints field, the report automatically generates data for the latest 10 sprints.
For DevOps Velocity5.1.11, Sprints field value is mandatory to generate the report. You must select minimum one sprint to generate the report.
- Click Confirm to run the report.
- Fields on the State of the Sprint Report page are detailed
in the following table:
Table 1. State of the Sprint Report page fields Field Description DATE Date, time, and email address of user who ran the report. STATUS Color-code status: Orange = STARTED, green = COMPLETE, and red = FAILED. View log Click View log to display log details for the report. View parameters Click View parameters to display the VIEW PARAMETERS OF EXECUTION window that indicates the Value Stream used for running the report. Share Click Share to copy the URL link for sharing the report. Results Click Results to view the State of the Sprint Report.

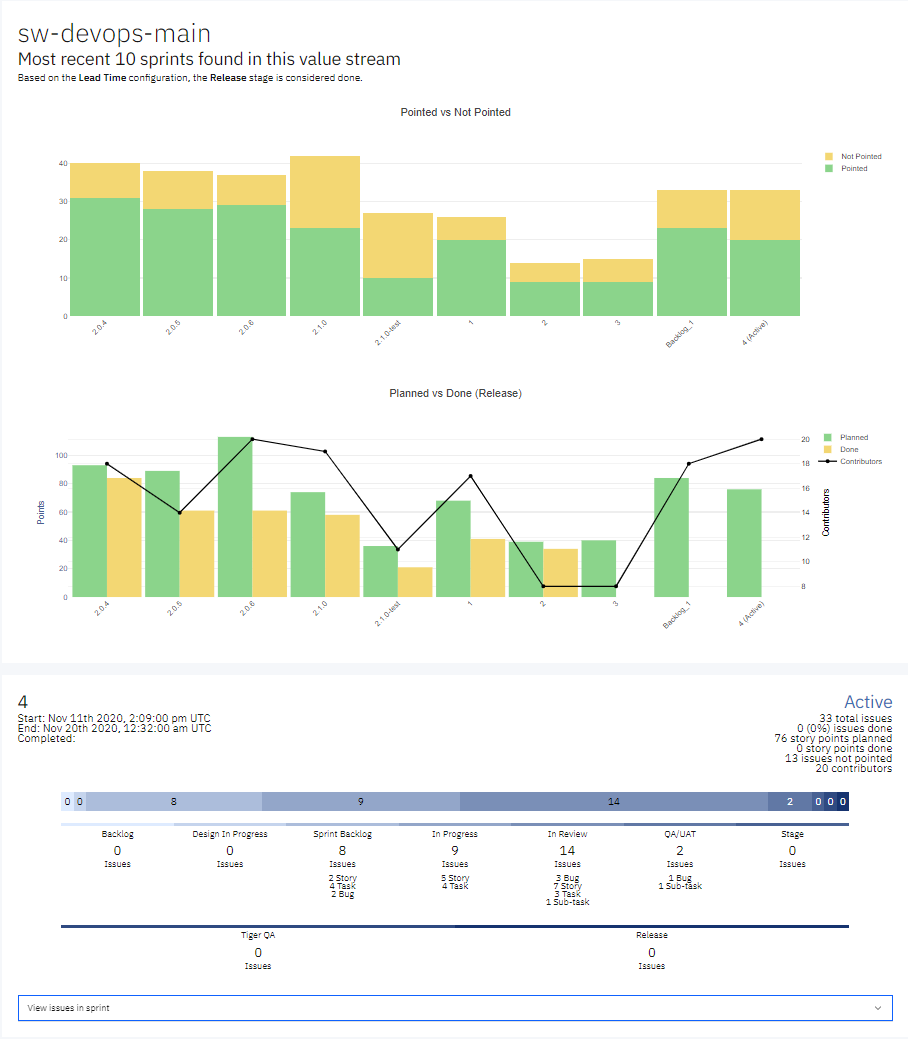

A sample State of the Sprint Report page is shown below.
The Pointed vs Not Pointed and Planned vs Done bar charts are both interactive and you can hover over any areas of the chart to dynamically display values and plot tool icons providing extended functionality. You can click on different areas of the blue shaded bar chart above to display the stage name with number of related issues.

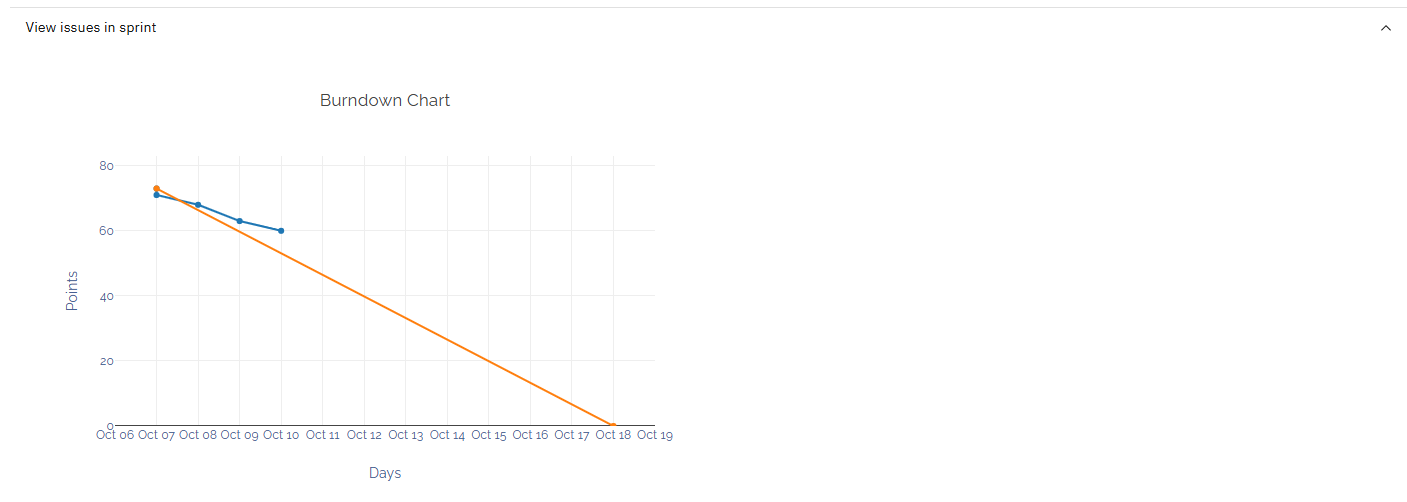

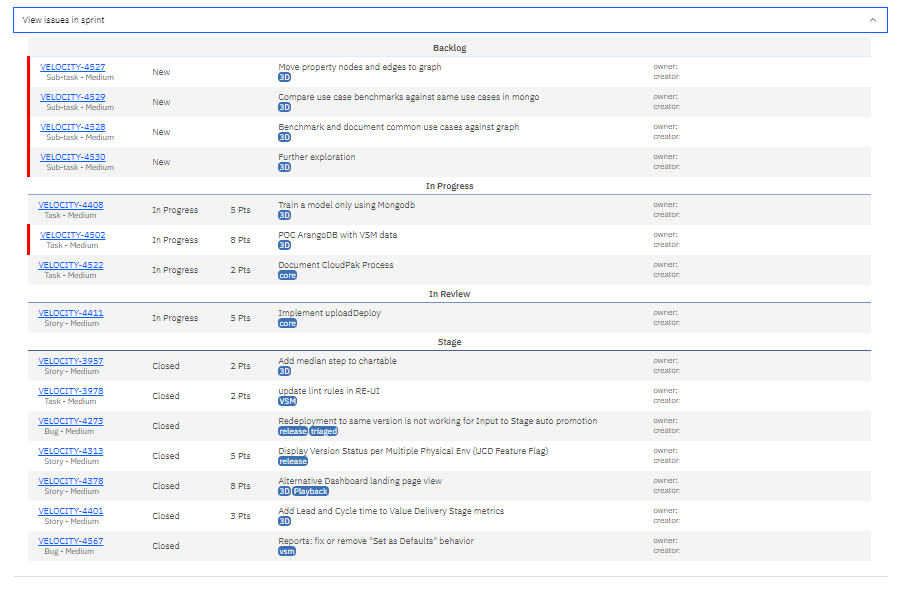

Click View issues in sprint bar to extend and display the burndown chart,
related issues for each stage of the value stream and the individual measures for the
developers who has contributed to the sprint.

The red vertical bar indicates alerts for issues such as over median time, no owner, and so on. You can click the issue link to open the ticket in a browser window to view detailed information for that item.
Individual Measures
The Individual Metrics section, available for each sprint, provides detailed insights into the contributions and performance of each contributor. This data is critical for engineering managers, product owners, and team leads to assess individual efficiency, promote accountability, and guide continuous improvement initiatives.
For every contributor who has participated during a sprint, the following metrics are displayed:
-
Number of Issues Completed
Tracks the number of tasks (stories, bugs, or technical items) a contributor has completed. This metric helps evaluate task throughput and individual contribution levels.
-
Total Story Points Completed
Measures the total effort delivered by a contributor based on the story points assigned to completed work items. This metric supports capacity planning and performance evaluation.
-
Number of Pull Requests Created
Indicates the frequency at which a contributor submits the code changes for review. This metric provides insight into coding activity and collaboration with peers.
-
Total Number of Commits
Shows the number of code commits made by a contributor, reflecting consistency, development cadence, and active involvement in coding tasks.
-
Dev Cycle Time
Measures the duration a contributor takes to complete a work item, calculated based on the specific stages you've configured for Dev Cycle Time within your value stream. This metric is useful for identifying delays, inefficiencies, or areas requiring support or process refinement.
-
Dev Cycle Time per Story Point
Normalizes Dev Cycle Time by story point size, allowing teams to evaluate individual efficiency relative to task complexity. This metric helps in identifying high-performing contributors or flag potential mismatches between estimated and actual effort.

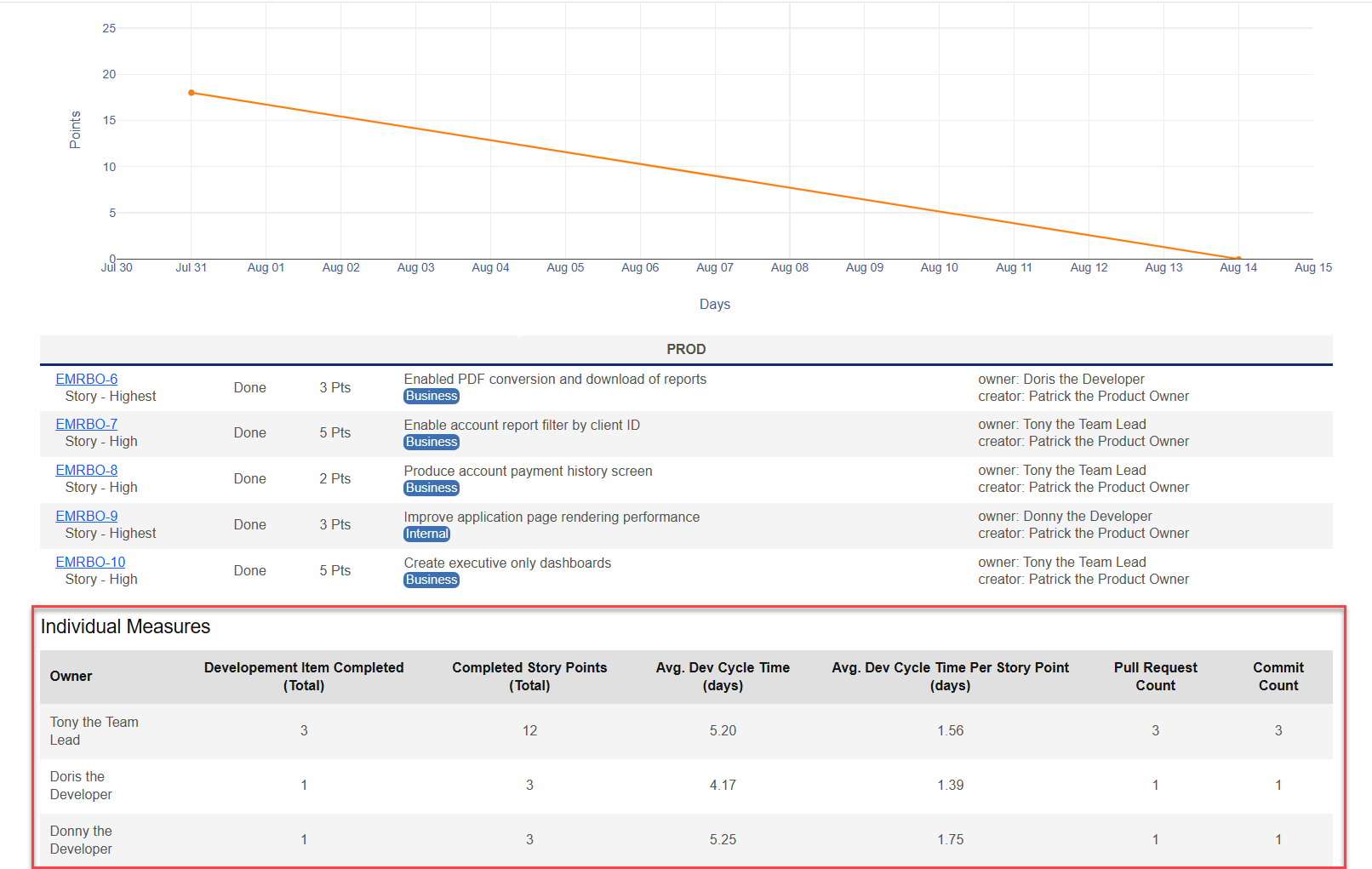

Individual Measures are displayed in a tabular format within the State of
the Sprint report, as shown in the following example, offering a clear
overview of the contributions and performance metrics of each contributor for a
given sprint.
